Resilience in the Face of Disaster: Arroyo–Guayama 48” WastewaterPipeline Stabilization
Project Overview
In September 2022, Hurricane Fiona struck Puerto Rico, leaving behind widespread flooding and devastation. Among the many hidden damages was a critical wastewater pipeline in Guayama, spanning over an unnamed creek. The storm’s floodwaters scoured the concrete piers supporting the crossing—piers that were already in critical condition. What remained was a precarious structure on the brink of failure, threatening both the environment and public health for thousands of families.
An Urgent Call for Action
With the pipeline in imminent danger, the Puerto Rico Aqueduct and Sewer Authority (PRASA) contracted ECR Engineering as part of an emergency project. The mission was twofold: deliver an immediate stabilization solution to avoid environmental catastrophe, and design a permanent structure that would guarantee long-term safety and reliability.
Overcoming the First Hurdles

The pipeline’s location near the coast made it highly vulnerable. Any collapse would have led to untreated wastewater spilling into the environment. The urgency of the situation demanded an interim solution while permanent designs were prepared. Engineers implemented a daring temporary measure: the installation of a 1,000-ton crane to support the pipeline, preventing collapse during the design phase.
Innovation Through Necessity

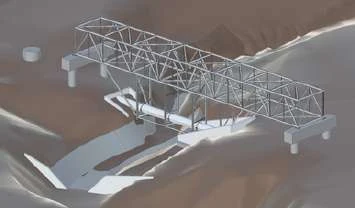

One of the decisive moments came when ECR rejected the idea of rebuilding piers on the creek banks. The site’s remoteness, combined with the difficulty of debris removal and limited maintenance access, made piers unsustainable. Instead, engineers proposed a galvanized steel truss bridge to support the pipeline from above—anchored on reinforced concrete abutments well beyond the creek’s reach.

This innovative structure required extreme precision in both design and fabrication. Using 3D Laser Scanning technology alongside conventional surveying, the team created a highly accurate model of the site. When installed, the truss aligned seamlessly with the existing pipeline, a testament to cutting-edge engineering and meticulous planning.
The Technical Approach
The permanent solution combined resilience with innovation:
• Galvanized steel truss bridge, supported on reinforced concrete abutments with deep drilled shafts. • Protective epoxy coating over the steel truss to withstand the harsh marine environment. • Reno and gabion mattresses and a new concrete grade control structure to protect the creek bed from further scouring.
Over the course of the pipeline’s 40-year lifespan, nearly 2 meters of creek bottom had been lost to erosion. The new design ensured this would not happen again.
Lasting Impact
By July 2024, the project was completed—delivering not just stabilization, but long-term security for the wastewater system. The pipeline continues to safely transfer wastewater to the Guayama Wastewater Treatment Plant, preventing what could have been a severe environmental disaster. The project benefits approximately 8,500 families, protecting both their communities and the surrounding ecosystem.
Recognition
In 2025, the Puerto Rico Institute of Environmental Engineers (CIAPR) awarded the project Outstanding Project of the Year, recognizing it as a benchmark in emergency response, innovation, and environmental protection.
At ECR Engineering, projects like this are not only about infrastructure—they are about protecting people, communities, and the environment when it matters most.
